GENERAL DESCRIPTIONS
2.1 The FMS Factory Model

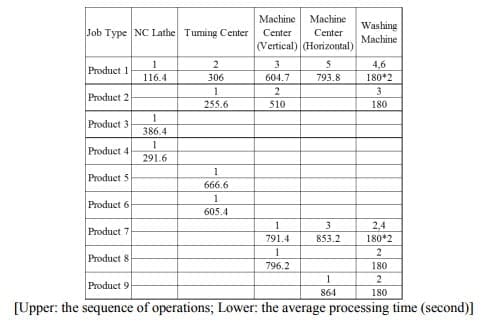

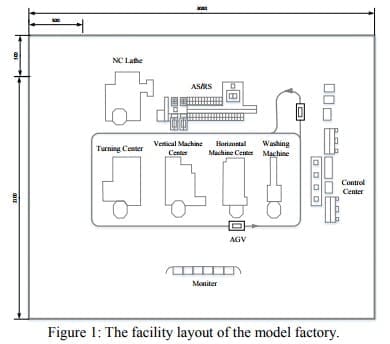

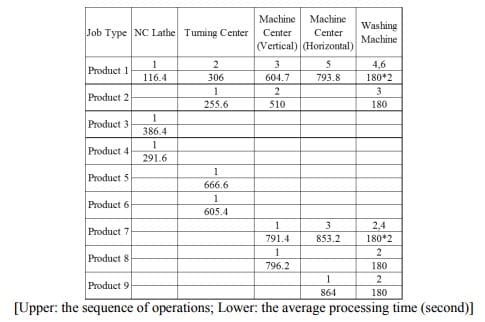

The system considered in this study is an FMS factory model (Takakuwa 1997) located at Chiba Prefecture, Japan. The FMS comprises four NC machine tools, (one NC lathe, one turning center, two types of machine centers (vertical and horizontal)), one washing machine, two AGVs, and one AS/RS with an industrial robot. The facility layout and the distance scale (unit: cm) of the FMS is shown in Figure 1. Workparts are transferred by the AGV and set up by the robot inside the AS/RS. Then, each workpart is loaded by the industrial robot associated with each machine tool prior to machining, then unloaded and after machining. The operation sequences and the associated historical average processing times (including the robot unloading and loading times) for selected workparts are summarized in Table 1. In addition, each workpart is set up for machining by the industrial robot inside the AS/RS before machining at the vertical (V.) machine center and the horizontal (H.) machine center. The AGV returns to the waiting area while idle.
Table 1: The machining sequence and average processing time of the products.
2.2 Shop Floor Control under the Industry 4.0 Environment
The fourth industrial revolution or Industry 4.0 is a collective term representing a number of technologies for automation, data exchange, and supply chain, including manufacturing systems via the Internet of Things (Takakuwa 2016; Wang et al. 2016). Customers’ mass production needs necessitate manufacturer responses to be quicker than ever before.
There are two types of integration in the Factory under the Industry 4.0 environment: vertical integration and horizontal integration. The former is integration from top management through the shop floor inside a factory, i.e., this integration occurs at the company level, the factory level, and the process level, as illustrated in Figure 2. The latter is integration between the suppliers, sales and distribution departments, and customers. In vertical integration, the interaction between the Enterprise Resource Planning (ERP) and Manufacturing Execution System (MES), in conjunction with data from the factory, is important.
Corporations use the ERP to collect, store, manage, and interpret data from various business activities,including procurement, production, distribution, accounting, human resource, sales, and customer services.
The ERP is important because the system monitors real-time data and transaction data in a variety of ways and also monitors shop-floor data and information in the Industry 4.0 environment. The ERP system typically falls short in production scheduling, and ERP solutions have several shortcomings that are widely recognized. For the most part, the ERP system and the day-to-day production remain disconnected. On the other hand, the MES is a control system for the associated shop floor. Manufacturing data are received from machines, equipment monitors, and workers. The MES is integrated with the ERP system.
In order to effectively make real-time decisions that are essential to the manufacturing system, realtime simulation is required. A real-time simulation is a simulated model of a physical system that can simulate processes at the same rate as the actual physical system executes them. the collection of production achievements, planning, instructions sent to the shop floor, and detailed records of performance are to be considered.
Furthermore, Automatic data-capturing systems using RFID or various type of sensors, which could trace and track shop floor data, disturbances and deliver solution adaptive to the real-time shop-floor changes (Khodke and Bhongade 2013).
3 SIMULATION MODEL
Simio Scheduling Tool
The simulation software and the scheduler developed by Simio LCC, is used in this research. Simio is a simulation-modeling framework based on graphical object-oriented programming. The model is realized using multiple modeling paradigms, including event, process, object, system-dynamics, and agentmodeling views (Thiesing and Pegden 2014). Furthermore, Simio is designed to support applications in both system design and scheduling and has several advanced features (Thiesing and Pegden 2015): integration with external relational data sources, transaction logging, specialized reports, customizable scheduler interface, interactive Gantt chart display, specialized scheduling rules, risk-based planning and scheduling (RPS), and others.

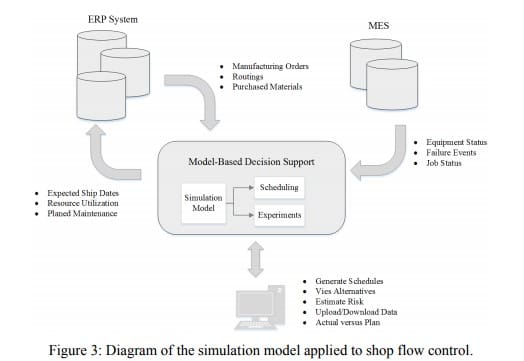

By connecting the MES and the Simio model, the real-time data acquired from MES can be used to generate the schedule. Furthermore, the job and resource transaction details are tracked in the log file while the model is running. The diagram of the simulation model applied for shop flow control is shown in Figure 3, that edited by authors based on Kelton, Smith, and Sturrock (2014).
3.2 Model Construction
The model in this study is developed using the Simio RPS tool. Data describing the current status of the system and the actual jobs to be processed through the system can be imported into the simulation model. This dataset typically contains a list of jobs to be processed, a bill of material for each job, job routings (including setup and processing times), etc. The table form of this data, based on the MES standard, is prepared in Data Tab. The mainly steps to construct the model in the study are shown below:
- Add the scheduling lists and tables to the product-based routing type;
- Define the tables with the specified object name and import data, as shown in Table 2 (the items in bold and italic font are the key column in the model);
- Modify the resource location to the defined position in the facility window (in proportion to Figure 1),
- Modify the Consume time and Produce time to 0, and set the Processing time (as shown in Table 1) for each processing step in the Processing Tasks menu.
- Add the vehicle and path to connect the source (Order Arrives), resources, and sink (Ship) in the facility window;
- Change the transport logic for each node that needs to transfer a workpart via a vehicle.
- Set the simulation time and run the model.

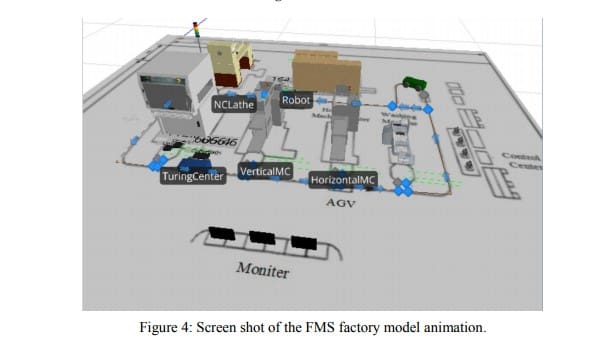

The model can be construct with these main steps and several minor changes. Figure 4 shows a screen shot of the FMS factory model animation. It should be noted that the animation pictures of the machines are not real ones, but are rather representative drawings selected from the symbol library.
The model can be validated and verified through the model animation and numeral tests with the simple order example.
4 APPLICATIONS

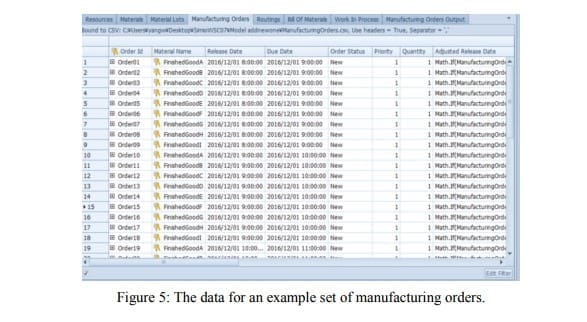

In this section, the scheduling experiments for the cases of a usual state and a new order is implemented. The initial product-mix numerical example uses 2 set (i.e., two pieces) of each product for the experiments. In the initial status, the order release date and the order due date are one hour apart, i.e., in the first working hour, orders arrive for one piece of each product. The due date of the first set orders is one hour after the start of the simulation, at which time the second set of orders for 1 set (i.e., one piece) of each product arrives. The data for an example set of manufacturing orders is shown in Figure 5.
4.1 The Scheduling Results of the Model

After importing the data table into the model, a schedule can be created in the Planning tab. The generated schedule under the First in First Out rule is shown in Figure 6. The Entity Workflow Gantt chart (Figure 6, right) shows the scheduling of the how jobs seize the resource, as well as the milestones and targets status for each order. In addition, the Resource Plan (Figure 6, left) shows how each resource in the system is utilized by the jobs. Furthermore, the activities of the entities and resources are traced by the usage Logs that display the shop floor at a defined time point. moreover, different resource dispatching approaches can be compared by setting the Ranking Rule and Dynamic Selection Rule under Resources.
4.2 The “Insert the new Orders” Case

In a real usage situation, there is a high probability that the system encounters a new order. If there is one order of product A and one order of product B received 30 minutes after production started (Order Release Time: 8:30; Order Due Time: 9:30). In this case, the Work in Process (WIP) order as well as the degree of progress made in the processing and the completed order can be confirmed through the output table. Furthermore, a VBA program is developed for generate WIP table using for rescheduling. The schedule generated under the Most Work Remaining rule at 8:30 is shown in Figure 7.
By loading the partially completed orders into the WIP table and importing the new orders (Order 19, Order 20) into the Manufacturing Orders table, the model can perform rescheduling. Figure 8 shows the Resource Plan Gantt chart when the system inserts two rush orders. Furthermore, in the processing sequence, Order 02 comes after the new order, Order 19, because of the defined rule for resource dispatching.
